How Independent Directors and Engineers Bridge the Gap Between Compliance and Corruption
This paper examines the structural decay of oversight institutions and proposes systemic reforms to restore genuine independence in corporate boards and public projects.
Executive Summary
The rise of independent oversight through directors in corporate boards and engineers in public projects was meant to safeguard integrity, transparency, and public trust.
Yet in practice, these guardians have become toothless tigers, symbolizing the illusion of independence in India’s governance ecosystem.
Both roles were conceived as buffers against conflict of interest, but have been structurally weakened by dependence on the very entities they are meant to oversee.
In corporate India, independent directors often serve at the pleasure of promoters.
in public works, independent engineers rely on project authorities for contracts and payments.
The result is a silent compliance economy where watchdogs bark only when convenient, and systemic corruption thrives beneath layers of procedural legitimacy.
This article examines how Independence has been monetized, turning oversight into a transactional bridge between compliance and corruption.
It calls for a rethink of accountability frameworks where independence is not just a designation, but a design of power, protection, and public purpose.
1. Introduction
Independence is the aspirational linchpin of modern governance. Independent directors in corporate boards and Independent Engineers in public infrastructure are conceived as the institutional firewall between public purpose and private rent‑seeking.
In theory, they dilute conflicts of interest, strengthen fiduciary care, and keep projects aligned with specifications, budgets, and timelines.
In practice, however, many of these guardians function as ceremonial placeholders.
Their powers are weak, their resourcing thin, and their tenure contingent on the goodwill of those they are meant to scrutinize.
This gap between design and delivery converts independence into a legitimacy‑laundering device: the mere presence of an independent actor becomes a certificate of integrity, even when substantive accountability is absent.
This paper asks a simple question with complicated implications: why do supposedly independent Directors and Engineers so often become toothless tigers?
It synthesizes statutory expectations, incentive structures, field dynamics, and emblematic case studies to show how oversight is routinely neutralized. It concludes with a reform agenda that treats independence as a design of power appointments, tenure, pay, data access, reporting rights, and liability rather than a nominal title.
1A. Historical Evolution of Oversight
The ideal of institutional independence traces its lineage to both Western corporate reform and Indian administrative philosophy.
In Britain, the Cadbury Report (1992) formalized non‑executive directors as custodians of shareholder interest after governance scandals.
In the United States, the Sarbanes–Oxley Act (2002) mandated independent audit committees and stricter disclosure following Enron and WorldCom.
In India, independence entered corporate governance through SEBI’s Clause 49 and later the Companies Act (2013).
Public projects adopted the Independent Engineer model from FIDIC,World Bank and ADB frameworks to arbitrate between contractor and client.
Over time, however, political patronage and contractual dependence transformed these guardians from neutral referees into instruments of procedural legitimacy.
2. The Promise and Prescription of Independence
Independence rests on the assumption that distance breeds objectivity.
In corporate governance, independent directors act as fiduciary stewards, chairing audit and risk committees under the Companies Act (2013) and SEBI’s LODR Regulations.
In public projects, Independent Engineers (IEs) review designs, inspect works, certify milestones, and adjudicate disputes imported from multilateral procurement frameworks to balance cost, quality, and time.
The intended promise: checks and balances, credible governance, continuity across leadership cycles, and a blend of technical and ethical correctives. The prescriptive frameworks look robust on paper, but practice has inverted them; independence often functions as presence without power.
3. The Political Economy of Oversight
Behind failed oversight lies a political economy that rewards silence.
The principal–agent problem persists when the monitor is paid by the monitored. Rent‑seeking equilibria distribute gains safely under legitimacy cover.
Moral hazard and network capture make dissent costly and compliance rewarding, while information asymmetry blinds external monitors who lack data rights and field time.
How Independence Gets Captured
Appointment Dependence
↓
Information Asymmetry
↓
Soft Coercion (Payments, Tenure)
↓
Ritual Compliance
↓
Legitimacy Shield (Use of Independence as Cover)
↓
Crisis / Scapegoating / Exit
4. Case Studies: When Independence Failed

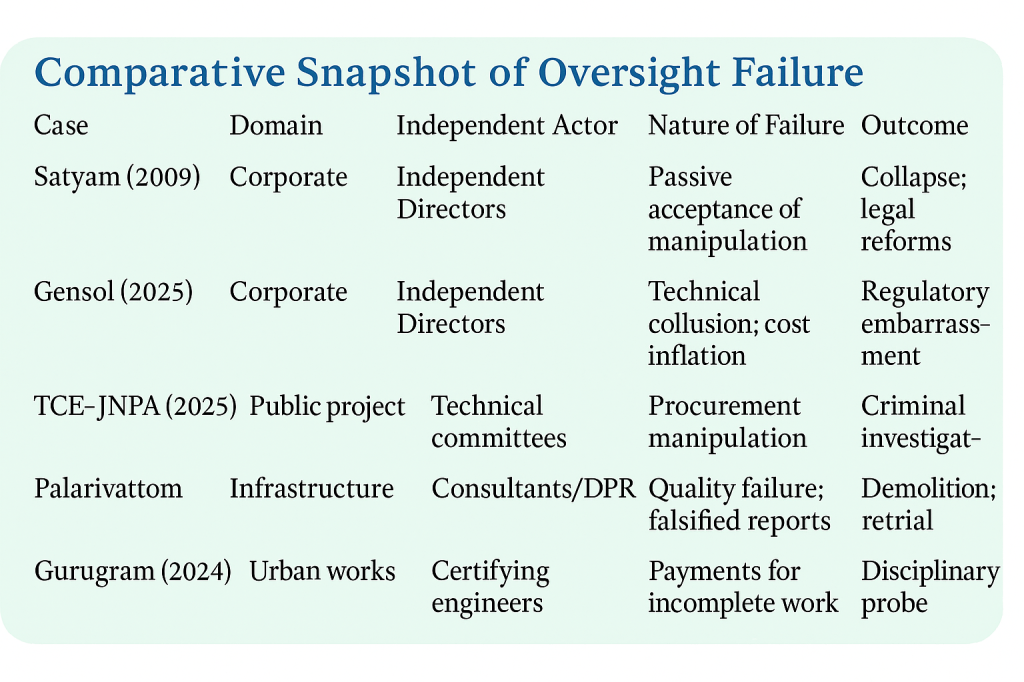

Corporate case studies reveal that independence on paper often dissolves in practice.
In boardrooms across India, Independent Directors intended as sentinels of governance are frequently reduced to spectators. The Satyam scandal showed how prestige replaced prudence;
Geasol’s resignations exposed the fragility of accountability when promoters hold the purse strings. Across industries, Independent Directors face a structural dilemma: they are expected to challenge those who appoint and compensate them.
As a result, their oversight frequently ends where confrontation begins.
A similar pattern echoes across public infrastructure, where Independent Engineers (IEs), designed to serve as neutral arbiters between Contractor and Client , face parallel pressures. Their contracts are financed and renewed by the very authorities they monitor, transforming independence into dependence by design.
This contradiction is most visible in HAM and BOT projects, where the consultant’s fee is structurally split—50 percent paid by the Concessionaire and 50 percent by the Authority.
While presented as a balance, this arrangement embeds a dual financial allegiance into the oversight architecture. The Independent Engineer is thus expected to adjudicate disputes, certify milestones, and enforce compliance against entities that directly control its remuneration and future engagement.
From expressways and smart city projects to ports and bridges,
this funding design mirrors the same conflict-ridden architecture that weakens corporate boards: neutrality is asserted in form, but compromised in substance.
The erosion of independence through financial subordination, contractual precarity, and procedural capture is not incidental it is systemic. Whether in boardrooms or project sites, oversight actors are asked to challenge those who appoint, pay, and renew them.
The result is predictable: vigilance gives way to accommodation.
Case Study 1: Satyam (2009): Board‑Level Oversight Breakdown
Founder Ramalinga Raju’s confession exposed inflated assets and fictitious cash balances. Multiple independent directors approved related‑party transactions, reflecting over‑reliance on management disclosures and audit assurances (Reuters 2009; TaxGuru 2023).
Case Study 2: Gensol Engineering (2025): Resignations Under Regulatory Heat
After SEBI barred the promoters for alleged fund misuse, three independent directors resigned, signalling the fragility of independence when underlying power lies elsewhere .
(Reuters 2025)
Case Study 3: Tata Consulting Engineers & JNPA Dredging (2025): Alleged Estimate Inflation
A CBI FIR alleged collusion between the PMC and officials to inflate estimates and curb competition, pegging losses at roughly ₹800 crore.
Independent technical opinions were reportedly sidelined.
(India Today 2025)
Case Study 4: Megha Engineering & NMDC/MECON/NISP (2024): Procurement Integrity Probe
CBI alleged bribery and undue influence in a ₹315‑crore contract, illustrating how technical adjudication and certification can be polluted, rendering independent oversight ineffective .
(Indian PSU 2024).
Case Study 5 Palarivattom Flyover (Kerala): Early Failure and Partial Demolition
Structural defects soon after inauguration raised questions about consultant independence, DPR quality, and oversight; technical risk signals were reportedly ignored or muted.(Wikipedia 2020; The Hindu 2020)
Case Study 6: Municipal Engineering Failures (Gurugram): Everyday Capture
Vigilance probes found payments cleared for incomplete or substandard works, echoing a pattern where certifying engineers functioned as rubber stamps rather than guardians (Times of India 2024).

Case Study 7: Delhi–Meerut Expressway (2019): Disputed Certification and Delays
The IE appointed for the ₹7,500-crore Delhi–Meerut Expressway faced allegations of certifying incomplete work packages and approving milestone payments before field verification.
A later CAG audit (2021) found cost escalation and delayed rectification, revealing the IE’s limited leverage against politically driven timelines.
The case showed that contractual dependence on NHAI compromised independent assessment.
Case Study 8: Smart City Mission (2020–2023): Cosmetic Compliance in IE Reports
Several Smart City projects (e.g., Bhopal, Pune, Lucknow) appointed Independent Engineers for third-party quality control. However, RTI responses and local audits showed identical wording in multiple city reports suggesting template oversight.
Engineers faced informal pressure to fast-track certifications so that progress dashboards met central reporting targets.
The IE function effectively became a compliance rubber stamp rather than a quality safeguard.
Case Study 9: Mumbai Coastal Road Project (2022): Oversight Overruled
The IE consortium flagged potential marine ecological risks and foundation deviations during piling. Instead of enforcing corrections, the contractor and project authority reportedly sidelined the warnings, citing urgency.
The IE’s dissent notes were not published, illustrating how contractual independence without statutory backing leaves oversight voiceless in megaprojects.
Case Study 10: Bihar Bridge Collapse (Aguwani –Sultanganj, 2023): Invisible Oversight Chain
After the under-construction bridge collapsed twice in two years, investigations found that the IE had repeatedly flagged design inconsistencies and material deviations, but the correspondence never reached the project authority’s top desk. The IE’s contract had no escalation clause. The episode epitomized the IE’s role as an unheeded messenger in politically sensitive projects.
Case Study 11: Navi Mumbai Airport (Ongoing): Performance Oversight by Design
Industry observers note that the IE framework for this PPP project is financially tied to milestone clearances. The more milestones certified, the faster the IE gets paid. This structural flaw incentivizes leniency and speed over rigour, making “
Independence financially self-defeating.
Case Study 12 : The Surat Water Tank Collapse, Gujarat
The recent collapse of a municipal water tank in Surat, Gujarat, offers a stark illustration of how formal oversight mechanisms can fail when independence is structurally compromised.
While technical investigations will apportion responsibility across design, construction, and maintenance, the governance failure is already evident.
Water storage structures are not high-risk novelties; they are standard public works, governed by well-established design codes, construction protocols, and inspection regimes.
Their failure, therefore, rarely stems from a lack of technical knowledge. Instead, it reflects breakdowns in supervision, certification, and the courage to dissent.
In the Surat case, multiple layers of oversight design consultants, construction supervisors, quality inspectors, and municipal engineers were theoretically in place.
Yet the collapse suggests that warning signals were either missed, diluted, or ignored.
This is consistent with a familiar pattern: engineers tasked with certifying safety often operate under financial and contractual dependence on the very authorities and contractors whose work they are expected to scrutinize.
Much like Independent Directors in corporate governance, project consultants in public infrastructure are expected to challenge timelines, reject substandard work, and halt unsafe practices.
In reality, such interventions carry costs delayed payments, strained relationships, non-renewal of contracts, or professional sidelining.
When oversight roles lack financial and tenure security, risk acceptance quietly replaces risk prevention.
The Surat collapse thus mirrors broader failures seen across sectors:
Independence exists on paper, but not in incentive structures Accountability is diffused, while responsibility concentrates only after disaster Post-event inquiries substitute for pre-emptive dissent
As with corporate scandals where Independent Directors later claim ignorance or helplessness, infrastructure failures reveal the same structural flaw.
Oversight actors are embedded in systems where challenging power is professionally unsafe, and compliance becomes the path of least resistance.
The lesson from Surat is not merely technical it is institutional.
Until engineers, inspectors, and consultants are insulated from financial contractual and political pressure, public safety will continue to rely on individual bravery rather than systemic integrity.
And when safety depends on courage instead of design, collapse is not an anomaly it is an outcome.
Infrastructure does not fail suddenly; it fails slowly, as silence accumulates layer by layer.
Case Study 13: Sairang, Mizoram — Railway Bridge Collapse (2023)
An under-construction railway bridge collapsed in Mizoram, killing dozens of workers. Under-construction failures typically involve temporary works—launching girders, staging systems, or erection sequences.
Temporary works often escape rigorous independent vetting because they are contractor-driven and schedule-sensitive. Consultants overseeing such works are frequently constrained by contractual dependence and fragmented responsibility, leading to diluted accountability.
Governance lesson: Oversight collapses first where supervision is weakest—temporary works—because independence is least protected.
Case Study 14: Ghatkopar, Mumbai — Hoarding Collapse (2024)
The collapse of a massive hoarding in Mumbai killed 17 people and injured many more. Stability certificates existed; permissions were granted. Yet the structure failed catastrophically.
This case exposes the rot in certification ecosystems, where structural approvals become paperwork exercises rather than engineering judgments. Certifying engineers operate within municipal empanelment and renewal systems that discourage confrontation.
Governance lesson: When certification becomes a commercial service instead of a public safeguard, independence is already lost.
Case Study 15: Morbi, Gujarat — Suspension Bridge Collapse (2022)
The Morbi pedestrian bridge collapsed days after reopening, killing over 140 people. The bridge had undergone repairs but was reopened without a robust, independent fitness audit.
Reopening pressure—festive timing, public optics—overrode technical caution. Engineers and inspectors either lacked authority or insulation to resist premature commissioning.
Governance lesson: Independence fails when safety audits are advisory, not mandatory gatekeepers.
Case Study16: Bihar — Repeated Bridge Collapses (2024 Pattern)
Multiple bridge collapses within a short period in Bihar revealed a systemic failure, not isolated accidents. Many structures were known to be distressed, yet remained operational.
Inspection, maintenance, and load regulation functions existed but were subordinated to budget constraints and political urgency. Engineers tasked with declaring structures unsafe face pressure because such declarations trigger closures, costs, and backlash.
Governance lesson: When inspection leads to punishment rather than protection, inspectors learn silence.
Case Study17: Ajmer, Rajasthan — Smart City Drain Collapse (2023)
A newly built drain under a smart city project collapsed soon after construction. Smart city projects often involve compressed timelines, bundled contracts, and consultant-heavy oversight.
In such environments, supervision becomes transactional. Consultants dependent on repeat municipal contracts hesitate to enforce strict quality controls that delay completion or escalate costs.
Governance lesson: Speed-driven urban missions structurally weaken independent supervision.
Case Study 18: Chennai, Tamil Nadu — Metro Construction-Related Building Damage (2023)
During metro construction, several adjacent buildings developed severe cracks, leading to evacuations. While not a sudden collapse, this slow-moving failure highlights inadequate risk mitigation and third-party assessment.
Designers, contractors, and supervising consultants operated in overlapping roles, blurring accountability. Affected residents faced prolonged uncertainty while responsibility was diffused.
Governance lesson: Independence fails when the same ecosystem designs, executes, and certifies risk mitigation.
Case Study19: Indore, Madhya Pradesh — Parking Structure Failure (2023)
A municipal parking structure developed major structural distress shortly after completion, forcing closure. Investigations pointed to poor workmanship and inadequate supervision.
Despite routine inspections during construction, defects went unchallenged. Supervisory engineers lacked both financial independence and tenure security, making aggressive enforcement unlikely.
Governance lesson: Quality failures are rarely invisible; they are often tolerated.
Case Study 20: Delhi NCR — Recurrent Building Collapses (2023–2024)
Multiple residential and commercial building collapses across Delhi NCR often during renovation or additional floor construction highlight chronic regulatory capture.
Structural engineers approving additions are paid by owners, while municipal enforcement is understaffed and politically constrained. The result is a market for compliant certification.
Governance lesson: When private payment controls public safety certification, collapse becomes cyclical.
Synthesis: The Pattern Is Not Technical It Is Institutional

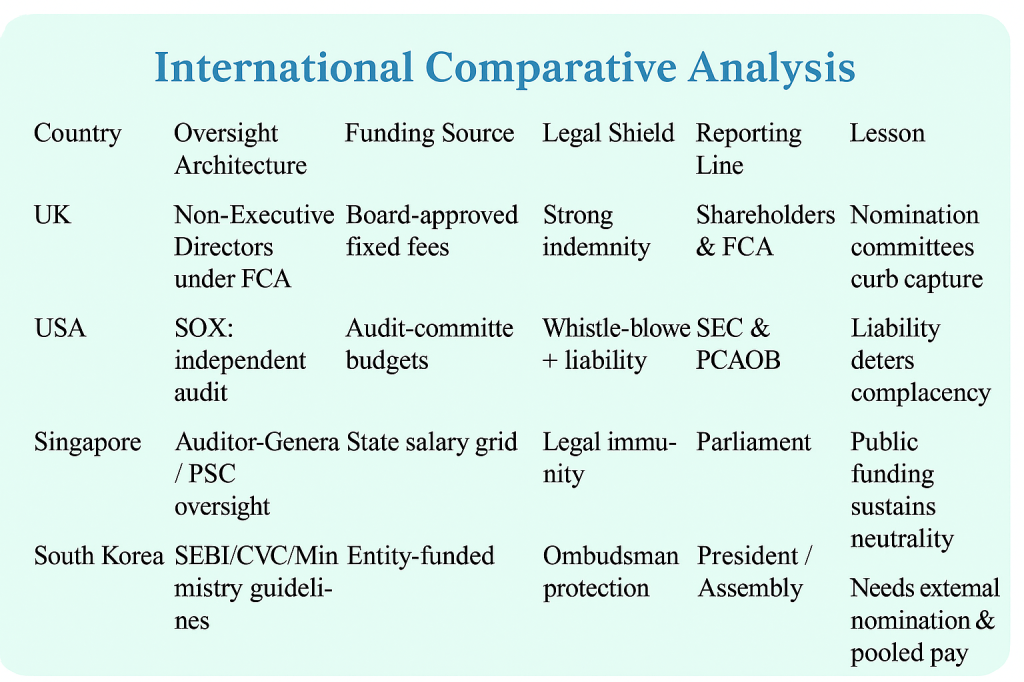

Below is a single, fully combined, coherent, and internationally aligned Harvard-style case study, integrating all prior elements—project context, tunnel failure incidents, oversight collapse, Independent Engineer integrity risks, procurement distortions, and governance lessons—into one seamless narrative.
Case Study 21: Oversight Failure in the Shimla Bypass Infrastructure Project
An Institutional Oversight Breakdown in a National Highway Megaproject
Public infrastructure megaprojects depend on robust institutional oversight to manage technical risk, safeguard communities, and protect public resources.
The Shimla Bypass Infrastructure Project, implemented as part of India’s national highway programme, presents a critical case of how formally sound oversight architectures can fail in practice. Despite the presence of multilayered supervision mechanisms, independent engineering oversight, and established procurement rules, the project experienced tunnel-related failures, community displacement, construction halts, and escalating administrative intervention.
This case examines how institutional weaknesses, procurement integrity risks, and incentive misalignment transformed nominal independence into ineffective oversight, offering broader lessons for global infrastructure governance.
I. Project Context
The Shimla Bypass was conceived as a strategic highway project to decongest a major Himalayan hill city and improve regional connectivity. Executed in geologically complex terrain, the project involved extensive tunnelling, hillside excavation, and construction in close proximity to existing settlements.
Given the environmental sensitivity and social risk profile, the project design incorporated multiple oversight layers:
A central highway implementing authority Project implementation units Independent Engineers (IEs) appointed through international competitive bidding Statutory clearances and monitoring requirements
On paper, the project reflected internationally accepted governance norms. In execution, however, critical failures emerged.
II. Emergence of Tunnel-Related Failures
From mid-2024 onwards, a sequence of incidents revealed mounting geotechnical stress and oversight gaps:
Ground subsidence and cavity formation were observed near active construction zones, leading to partial road collapse and emergency site inspections. Progressive cracking of residential structures was reported by local communities, initially dismissed as minor or unrelated. In early-2026, multiple families were evacuated after cracks widened rapidly, triggering public concern and administrative intervention. Local authorities imposed temporary bans on blasting and construction, acknowledging the severity of the risk.
These events indicated that early warning signals existed but were either underestimated, insufficiently escalated, or inadequately acted upon.
III. Oversight Architecture and Its Limitations
Large national highway projects typically rely on the Independent Engineer as a cornerstone of governance. The IE is expected to act as an impartial technical authority, responsible for:
Validating designs and construction methodologies Monitoring safety, quality, and compliance Certifying milestones, payments, and variations Escalating risk independently of the implementing authority
In the Shimla Bypass project, this role was contractually established through an international procurement process designed to ensure competence and independence.
Yet the persistence and escalation of failures raise a central analytical question:
Why did an oversight system that existed in form fail in function?
IV. Procurement Integrity Risks and “White Collared Innovated Technical Corruption”
This case does not allege adjudicated wrongdoing.
Instead, it analyses structural vulnerabilities widely recognised in global infrastructure governance.
1. Bid Composition and Qualification Inflation
International consultancy procurement often rewards bid teams that combine:
Highly credentialed foreign experts Senior domestic professionals Additional personnel assembled to maximise technical scoring
While formally compliant, such configurations can obscure the gap between declared expertise and on-site deployment, especially where verification of personnel authenticity and availability is weak.
2. Post-Award Dilution of Expertise
A recurring risk in megaprojects is post-award substitution, where:
Bid-stage experts are not meaningfully involved during execution Oversight becomes checklist-driven rather than judgement-driven Critical decisions rely on diluted technical capacity
In high-risk tunnelling environments, this erosion of expertise can have direct safety consequences.
3. Mutual Dependency Between Authority and Oversight
When the implementing authority:
Selects and remunerates the Independent Engineer Relies on IE certifications to justify payments and variations Exercises discretion over contract extensions
a mutual dependency loop may arise. Independence becomes constrained not through overt collusion, but through aligned institutional incentives.
This dynamic facilitates what governance literature terms White Collared Innovated Technical Corruption procedural compliance that masks:
Risk suppression Cost inflation Retrospective justification of variations
V. Cost Escalation, Variations, and Oversight Blind Spots
Tunnel projects often cite geological uncertainty to justify scope changes and cost overruns. However, the Shimla Bypass case highlights a governance dilemma:
Were risks genuinely unforeseeable, or Were conservative assumptions relaxed to accelerate execution and defer accountability?
VI. Community Interface and Governance Failure
Community complaints constituted early risk signals:
Reports of vibration Minor structural damage Repeated representations to site authorities
These signals were not integrated into formal risk registers until damage became severe. The absence of responsive grievance redress and third-party verification delayed corrective action and eroded public trust.
VII. Analytical Synthesis: Why Oversight Failed
The failure was not institutional absence, but institutional hollowing:
Independence without enforceable autonomy Expertise without sustained deployment Transparent procurement without post-award integrity controls Risk monitoring without escalation authority Community feedback treated as disruption rather than data
Oversight existed, but functioned symbolically rather than substantively.
VIII. Global Relevance
Comparable failures have occurred internationally in tunnels, metros, dams, and highways where:
Independent oversight existed formally Incentives discouraged early challenge Risks were acknowledged only after materialisation
The Shimla Bypass thus fits a global pattern in infrastructure governance failures.
The Shimla Bypass Infrastructure Project demonstrates that oversight failure in megaprojects is rarely accidental.
It emerges from procurement design choices, incentive alignment, and tolerance for procedural compliance over substantive scrutiny.
For policymakers, regulators, and development institutions worldwide, the lesson is clear:
Independent oversight must be structurally protected, integrity-driven, and empowered to intervene otherwise it risks becoming a professional formality rather than a public safeguard.
Across all cases:
Codes existed Engineers existed Consultants existed Certifications existed
What failed was independence backed by incentives.
Oversight actors were expected to challenge: Those who paid them Those who renewed them Those who could replace them
This is not negligence by individuals it is failure by design.
India does not suffer from a shortage of engineers or rules; it suffers from systems that punish independence and reward compliance.
5. How Independent Roles Bridge Compliance and Corruption
Independence was designed as the bridge between power and accountability, yet captured systems convert it into the bridge between compliance and corruption.
Directors sign minutes and RPT approvals; engineers certify milestones satisfying formal checklists while substantive quality and integrity decay beneath the surface.
The presence of independent signatures deflects blame the Independent Engineer certified it.
When scandals erupt, independents either absorb blame or resign, offering distance without remedy. The result is compliance theatre.
6. Reforming Independent Oversight: From Symbolism to Substance
A functional framework rests on three pillars:
Structural Insulation
Transparency Backbone
Integrity Incentives.
Together, these transform independence from ritual to reinforcement.
6.1 Structural Insulation
• Insulated appointments via regulator‑convened panels; prevent promoter/department capture.
• Fixed, non‑renewable tenure to remove re‑appointment pressure.
• Independent remuneration pools (escrow) overseen by regulators or trustees.
• Protected removal requiring disinterested shareholder vote or transparent justification.
6.2 Transparency Backbone
• Public dashboards for inspection reports, IE certifications, and board minutes (redacted).
• Digital twins and IoT sensors for real‑time verification of progress and quality.
• Citizen and professional audits of randomised project samples.
• RTI parity for PPP/SPV entities handling public funds.
6.3 Integrity Incentives
• Safe‑harbour clauses protecting good‑faith dissent and escalation.
• Public recognition and awards for substantive oversight interventions.
• Penalties for habitual rubber‑stamping and wilful blind spots.
• Rotation of independents; meta‑audit to ‘audit the auditors’.
Reform Architecture Model
Structural Insulation
↓
Transparency Backbone
↓
Integrity Incentive Model
↓
→ Trustworthy Governance ←
6A. International Comparative Analysis
Comparative practice shows that jurisdictions which truly empower independence design it into law, money, and reporting lines.
The following table summarises structural contrasts and lessons for India.

7. Policy Summary and Conclusion
Five Levers for Real Independence:
1) Insulated Appointments
2) Independent Funding
3) Mandated Escalation
4) Transparent Dissent & Disclosure
5) Rotational Oversight & Citizen Access
Each lever closes a fracture in the oversight chain: appointments insulated from capture, money separated from influence, escalation made mandatory, dissent made visible, and roles refreshed to resist capture. Together they convert independence from a personal virtue into a systemic guarantee.
True independence is freedom from consequence in the public interest: the ability to speak truth without reprisals. Without structural redesign, boards and projects will continue to parade toothless tigers while integrity erodes.
References
Cadbury Committee (1992) Report of the Committee on the Financial Aspects of Corporate Governance. https://ecgi.global/sites/default/files/bromley/files/cadbury_code_1992.pdf
Clarke, T. (2007) International Corporate Governance: A Comparative Approach. Routledge. https://www.routledge.com/International-Corporate-Governance/Clarke/p/book/9780415324833
Government of India (2013) Companies Act 2013. Ministry of Corporate Affairs. https://www.mca.gov.in/content/mca/global/en/acts-rules/companies-act/companies-act-2013.html
Hood, C. (2011) The Blame Game: Spin, Bureaucracy, and Self‑Preservation in Government. Princeton. https://press.princeton.edu/books/paperback/9780691156199/the-blame-game
Power, M. (1997) The Audit Society: Rituals of Verification. OUP. https://global.oup.com/academic/product/the-audit-society-9780198296034
Flyvbjerg, B. (2023) How Big Things Get Done. Currency. https://www.penguinrandomhouse.com/books/704840/how-big-things-get-done-by-bent-flyvbjerg-and-dan-gardner/
Ng, T. & Pierce, L. (2021) The psychological costs of organizational wrongdoing. Annual Review of Psychology. https://www.annualreviews.org/doi/10.1146/annurev-psych-062520-122309
Sethuraman, S. & Kothari, V. (2024) Liability of Independent Directors in India. NUJS Law Review. https://nujslawreview.org/2024/08/10/liability-of-independent-directors/
Azmi, R. & Khosrow‑Panah, I. (2017) Blockchain for public procurement transparency. arXiv. https://arxiv.org/abs/1701.06426
World Bank (2010) Fraud and Corruption Awareness Handbook for Civil Works. https://documents.worldbank.org/en/publication/documents-reports/documentdetail/806391468151785501/fraud-and-corruption-awareness-handbook-for-civil-works
Reuters (2009) Timeline: Satyam’s scandal shakes India Inc. https://www.reuters.com/article/us-satyam-idUSTRE50E2RY20090115
Reuters (2025) Independent directors exit Gensol after co‑founders probed, 18 April. https://www.reuters.com/world/india/independent-directors-exit-indias-gensol-after-co-founders-probed-2025-04-18/
India Today (2025) CBI case against Tata Consulting Engineers and officials in ₹800‑crore project fraud. https://www.indiatoday.in/india/story/cbi-case-against-tata-consulting-engineers-government-officials-in-rs-800-crore-project-fraud-2743829-2025-06-20
Indian PSU (2024) CBI FIR against Megha Engineering and officials of NMDC, MECON, NISP. https://indianpsu.com/cbi-fir-against-megha-engineering-and-ten-officials-of-nmdc-mecon-and-nisp-for-corruption-in-rs-315-crore-project/
Times of India (2024) Payments cleared for incomplete works: 12 MCG engineers under scanner. https://timesofindia.indiatimes.com/city/gurgaon/payments-done-work-incomplete-12-mcg-engineers-under-scanner/articleshow/120909748.cms
Wikipedia (2020) Palarivattom Flyover Scam. https://en.wikipedia.org/wiki/Palarivattom_Flyover_scam
Leave a Reply
